Recycling demolition waste is defined as the systematic recovery of materials from building deconstruction and demolition activities to divert debris from landfill and reintroduce it into construction supply chains. The industry term for this practice is construction and demolition waste (CDW) management, and it sits at the centre of both regulatory compliance and circular economy strategy. Conventional mechanical demolition recovers only 20–40% of materials by weight, whereas selective deconstruction pushes that figure to 70–90%. The gap between those two numbers represents both a compliance risk and a significant missed revenue opportunity for any contractor or project manager operating in 2026.
Conventional mechanical demolition uses excavators and wrecking equipment to bring a structure down rapidly. The process is fast and cost-effective on the surface, but the mixed debris it produces makes material separation difficult, which is why recovery rates sit at 20–40%. That figure means the majority of potentially reusable concrete, timber, and metal ends up in landfill.
Selective deconstruction reverses that outcome by dismantling a building component by component in a planned sequence. Structural steel is unbolted rather than sheared, timber is carefully extracted, and fixtures are removed intact for resale. Recovery rates of 70–90% are achievable through this method, and the BRE Birmingham school case study demonstrated 82% material recovery alongside a 12% net cost saving once landfill tax avoidance and resale revenue were factored in. That outcome directly challenges the assumption that deconstruction is always the more expensive option.

Adaptive reuse takes a third path entirely by converting an existing structure for a new purpose rather than demolishing it. This approach eliminates CDW at source and is increasingly favoured under ESG frameworks and sustainable building practices. Where full adaptive reuse is not viable, a hybrid approach combining partial strip-out with selective deconstruction often delivers the best balance of speed and recovery.
| Method | Recovery rate | Labour cost | Key advantage |
|---|---|---|---|

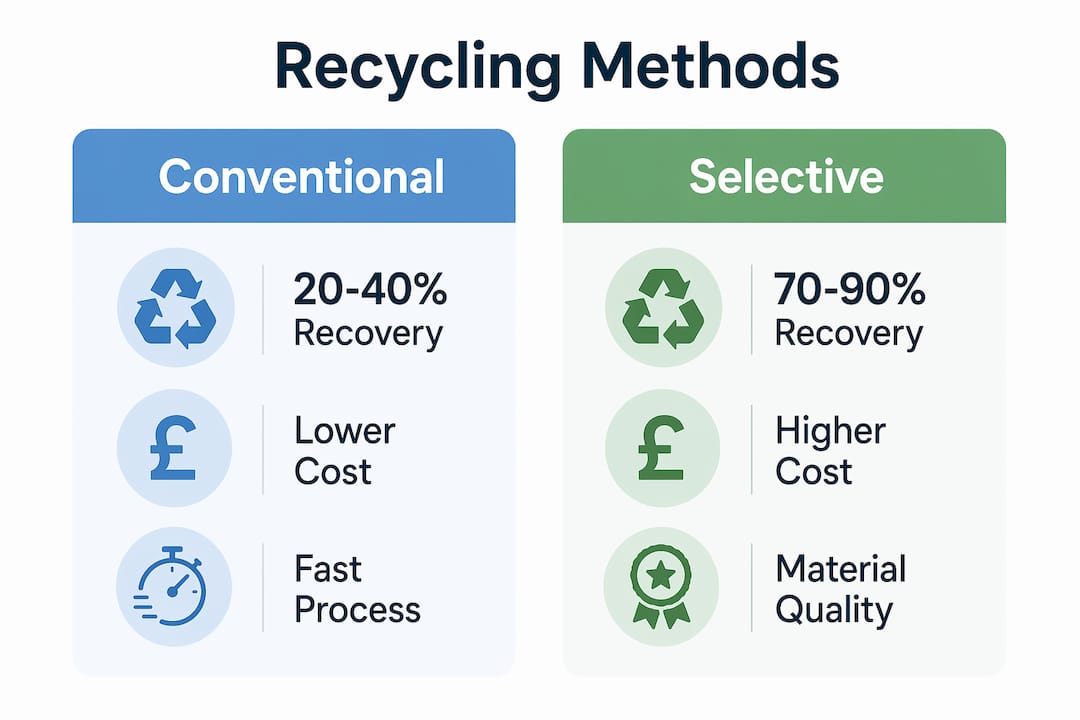

| Conventional demolition | 20–40% | Low | Speed and low upfront cost |
| Selective deconstruction | 70–90% | 15–40% higher | High material recovery and resale revenue |
| Adaptive reuse | Near 100% | Variable | Eliminates demolition waste entirely |
Pro Tip: Selective deconstruction takes 2–5 times longer than mechanical demolition, so build that timeline into your programme from the outset. Failing to account for it at tender stage is the single most common reason projects exceed budget.
Regulatory compliance in waste management for demolition projects is non-negotiable in 2026. In California, CalGreen mandates a minimum 65% debris diversion rate for all construction and demolition projects, with some jurisdictions proposing 70% targets. UK frameworks set comparable landfill diversion expectations, and both systems require documented evidence rather than self-reported estimates.
A Construction Waste Management Plan (CWMP) must be submitted before work commences. The plan should identify each waste stream by material type, specify the licensed facility receiving each stream, and project the diversion percentage. Weight tickets must be maintained for every waste load leaving the site. Without them, you cannot demonstrate compliance at final inspection, and the penalties for failure range from project delays to financial fines.
Common compliance failures include:
A pre-demolition survey is the most reliable way to identify hazardous materials, quantify recoverable volumes, and build an accurate CWMP before any machinery arrives on site.
Pro Tip: Appoint a dedicated waste coordinator on larger projects. This person owns the weight ticket log, liaises with licensed processors, and updates the CWMP in real time. Projects with a named coordinator consistently pass compliance inspections with fewer queries.
The most significant shift in material recycling in demolition over the past three years is the adoption of digital planning tools before a single wall comes down. Building Information Modelling (BIM) allows project teams to map every material in a structure, assign it a recovery category, and sequence the deconstruction to protect high-value components. AI-driven demolition sequencing builds on BIM data to optimise the order of operations, reduce carbon footprint, and identify the most efficient logistics routes for each material stream.
On site, physical sorting technology determines whether recovered materials actually re-enter supply chains or end up downgraded to aggregate. The core equipment includes:
Steel recycling is a closed-loop process with no loss of quality across infinite cycles, making it one of the highest-value streams on any demolition site. Copper, brass, and structural steel recovered intact command scrap prices that can directly offset deconstruction labour costs.
The concept of a ‘virtual resource recovery plant’ takes this further by coordinating transport logistics, processing capacity, and end-market demand across multiple sites simultaneously. Rather than treating each demolition project as an isolated waste event, this model aggregates material flows to achieve the volumes that commodity buyers and recycling processors require. It is particularly relevant for contractors managing multiple urban redevelopment projects concurrently.

Pro Tip: Contact scrap metal merchants and reclaimed material dealers before demolition begins, not after. Knowing the current market price for structural steel or reclaimed brickwork allows you to sequence the strip-out to protect those materials and negotiate collection contracts in advance.
The most costly mistake in CDW management is underestimating the planning time required for selective deconstruction. Contractors who price a project on mechanical demolition rates and then attempt to recover materials for compliance purposes end up with neither the speed nor the recovery rates they need. The planning phase for a deconstruction-led approach must include a material audit, sequencing plan, and confirmed routes to market for each recovered stream.
Poor documentation is the second most frequent failure. Contractors who lack proper documentation face penalties and project delays that far exceed the cost of maintaining a compliant record-keeping system. Every subcontractor on site must understand their obligation to retain weight tickets and submit them to the waste coordinator.
Key mistakes and their corrective actions:
Viewing demolition debris as a reliable raw material stream rather than waste aligns with circular economy and ESG standards, creating long-term economic resilience for contractors who adopt this mindset consistently.
Effective recycling of demolition waste requires selective deconstruction methods, a compliant Construction Waste Management Plan, and technology-led sorting to maximise both material recovery and financial return.
| Point | Details |
|---|---|
| Choose the right method | Selective deconstruction recovers 70–90% of materials versus 20–40% for conventional demolition. |
| Submit documentation early | A Construction Waste Management Plan and weight tickets are mandatory before work commences. |
| Use technology to sort | BIM, AI sequencing, and physical separators maximise the quality and value of recovered materials. |
| Monetise high-value streams | Steel, copper, and brass recovered intact offset deconstruction labour costs through scrap resale. |
| Avoid contamination | Segregate hazardous materials at source to protect recyclable loads from rejection at processing facilities. |
The conversation around sustainability in demolition has shifted considerably in the past few years, but I still see too many projects where recycling is treated as a compliance exercise rather than a commercial one. The BRE Birmingham school result, 82% recovery and a 12% net cost saving, is not an outlier. It is what happens when a project team plans for material recovery from day one instead of retrofitting it at the end.
The contractors who will be best positioned in 2026 and beyond are those who have built relationships with scrap merchants, reclaimed material dealers, and recycled aggregate processors before they need them. When you know the current price for structural steel and you have a buyer lined up before demolition starts, the economics of selective deconstruction change entirely. The labour premium becomes a procurement cost, not an overhead.
Viewing demolition sites as resource hubs rather than waste sources is not a philosophical position. It is a practical response to rising landfill tax, tightening diversion targets, and clients who are increasingly asking for ESG-aligned project delivery. The regulatory pressure is only going in one direction. The contractors who have already built the systems and supplier relationships will have a genuine competitive advantage over those who are still treating CDW as a disposal problem.
