Section 61 of the Control of Pollution Act 1974 lets contractors apply for prior consent to carry out noisy or vibration-heavy construction work. Get it granted and comply with the conditions, and your local authority cannot then serve a Section 60 notice for the same works. The next move is straightforward: draft your application and get it in front of the environmental health officer early, because the statutory clock runs to 28 days once a formal submission lands.
TL;DR:
- Applying early for Section 61 consent helps contractors secure lawful working conditions and avoid reactive noise restrictions through Section 60 notices.
- A comprehensive application must include sound modeling, detailed plant lists, proposed hours, monitoring plans, and resident notification strategies to meet approval criteria.
- Engaging in a drafted consultation six weeks prior to work start allows for adjustments based on environmental health officer feedback, increasing chances of approval.
- Changes to existing consents, such as extensions or temporary exceptions, require separate applications, with tracking and documentation crucial for defending against complaints.
- Success depends more on timing and being detailed and realistic in modeling than on the amount of paperwork completed.
Section 61 gives contractors something rare in construction law: a way to get ahead of enforcement rather than react to it. The statutory provision allows an application for prior consent to carry out works likely to generate noise or vibration, and it is entirely voluntary. Nobody forces you to apply. But once a council grants consent and you stick to its terms, that consent becomes a shield.
Compare that with the alternative. A Section 60 notice is the council’s enforcement tool, imposed reactively once noise has already become a problem for neighbours. It can dictate working hours, ban certain plant, and cap noise or vibration levels, often at short notice and mid-programme. That is expensive to absorb once a piling rig is already on site.

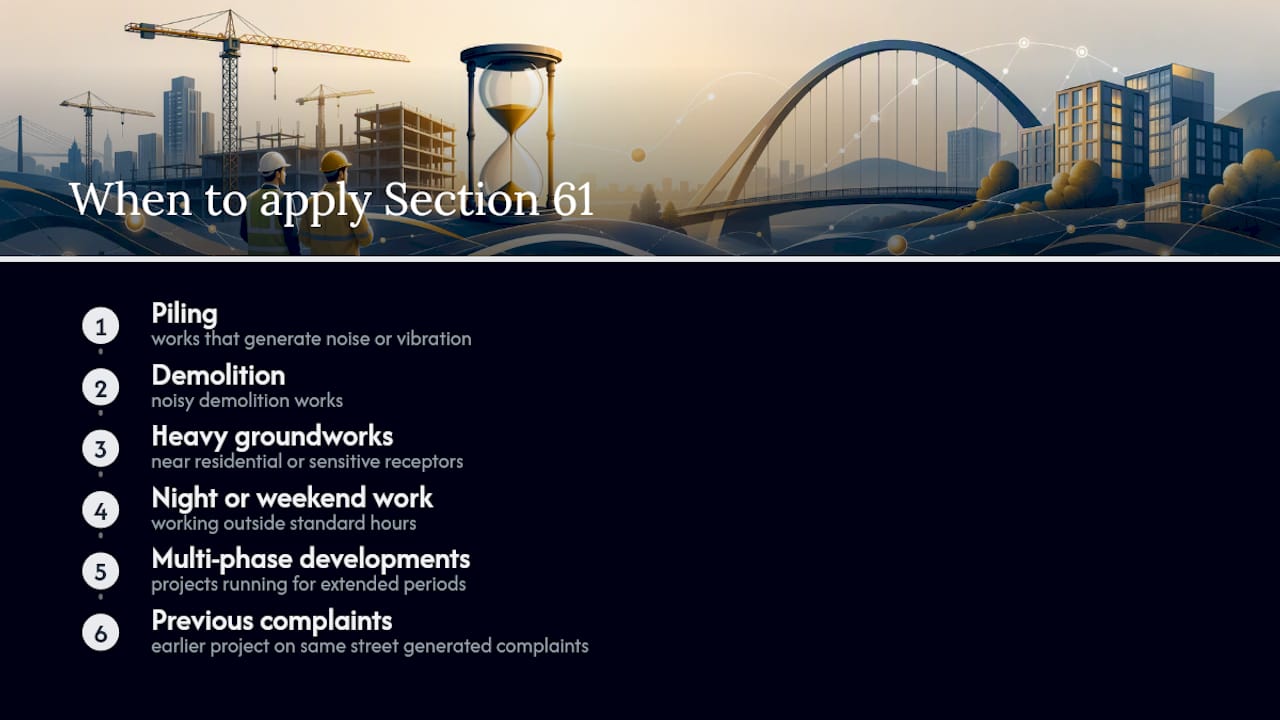

Councils tend to expect a Section 61 application for piling, demolition, or heavy groundworks near residential or sensitive receptors, night-time or weekend working outside standard hours, multi-phase developments running for an extended period, and sites where an earlier project on the same street generated complaints

Contractors who apply early are not just ticking a box. They are buying certainty. Once consent is granted on agreed terms, the goalposts stop moving.
The application should come from whoever is actually running the site, not the developer’s head office. In practice, that means the principal contractor or a named company director or site manager with the authority to commit to the working methods described in the application. Councils want a real point of contact, not a generic company name.
Most local authority forms ask for:
Signing the application does not end your obligations. The named applicant carries responsibility for every subcontractor working under that consent, which means piling subcontractors, demolition crews and even short-term plant hire firms all need briefing on the agreed hours, plant restrictions and monitoring commitments. Councils expect the principal contractor to retain monitoring records and daily logs for the life of the works, and to produce them on request. If an Environmental Health Officer turns up unannounced and asks for last week’s noise readings, “we’ll dig them out” is not a good answer.
Applications get rejected or delayed for the same handful of reasons every time: missing technical detail, vague working hours, or no evidence that noise has actually been modelled. Councils are not looking for perfection. They are looking for proof you have thought it through.
A complete submission generally needs:
The strongest applications treat resident notification as more than a legal nicety. A letter drop two weeks before piling starts, with a named contact number and expected duration, heads off complaints before they start.
Pro Tip: Model your worst-case scenario, not your average day. If your piling rig runs at full capacity for three consecutive days early in the programme, predict that scenario specifically rather than an averaged figure across the whole job. Councils spot averaged-down predictions immediately, and it undermines trust in the rest of your submission.
Submitting a final application cold, with no informal conversation first, is one of the most common mistakes contractors make. The three-stage process runs preparatory, draft, then final. Skip the draft stage and you are effectively asking the council to accept your working methods blind.
For anything beyond a small domestic job, submit a draft application roughly six weeks before works are due to start. That gives the Environmental Health Officer time to review your predictions, raise concerns, and propose draft conditions before anything is locked in statutorily.
The 28-day statutory window only bites once you submit the formal, final application. Draft consultation sits outside that clock entirely, which is exactly why it is worth the extra weeks upfront. Rushing straight to a final submission without draft feedback is a false economy that regularly produces rejected applications or conditions far tighter than necessary.
Projects change. Piling methods get revised, working hours shift, new plant arrives on site. A variation amends the terms of an existing consent, while a dispensation is a short-term, specific exception, typically used for a one-off event such as an unplanned overnight concrete pour or an urgent structural repair.
Treat the application as a programme milestone with its own lead time, not an afterthought bolted onto the works package.
Pro Tip: Keep a single, dated complaints log from day one, even if you receive nothing in the first month. An empty log with consistent dates is stronger evidence of good management than no log at all if a dispute ever reaches a council review.
Councils treat compliance with BS 5228, the Code of Practice for Noise and Vibration on Construction and Open Sites, as the baseline standard for any technical prediction in a Section 61 application. The standard covers both noise prediction methodology and vibration guidance, including annexes that many EHOs refer to directly when assessing submissions.
Real-world conditions show what councils actually accept in practice. One Cambridge planning condition specified preference for quieter CFA piling methods over percussive alternatives, alongside hoarding and phased sequencing to avoid running multiple noisy operations simultaneously. That is the level of specificity worth matching in your own submission.
Gcscontractors has built a working checklist for every project where noise or vibration consent is likely to be needed, covering groundworks, demolition, and civil engineering packages across Cambridge and East Anglia. The approach starts at tender stage, not after mobilisation, because retrofitting a mitigation strategy onto an already-programmed job rarely works.
Contractors managing their own Section 61 submission for the first time often underestimate the lead-in time, particularly around draft consultation. If you want a second opinion on your working methods or mitigation plan before submission, Gcscontractors’ strip-out and demolition guidance sets out the site preparation standards that typically underpin a strong application.
Start with the primary legislation and your specific local authority’s own template, since forms and expectations differ between councils.

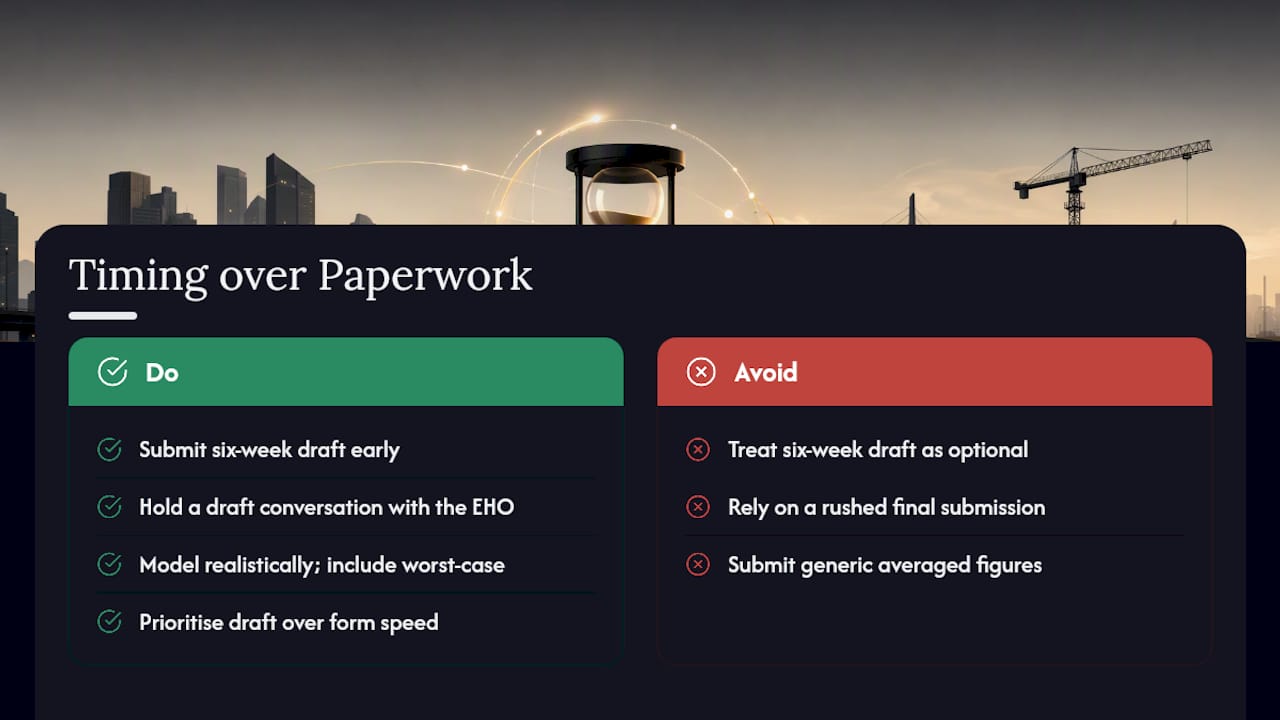

Most guidance on Section 61 fixates on the form itself: what boxes to fill in, what plant list format to use. That misses the actual lever that determines whether an application succeeds. Timing does more work than paperwork ever will.

The six-week draft submission is routinely treated as optional by contractors under programme pressure, and that is the single biggest mistake in this entire process. A rushed final submission with no prior conversation puts the EHO in a defensive position: they have never seen your numbers before, so they impose the most cautious conditions available to them. A draft submitted early does the opposite. It turns the EHO into someone who has already tested your predictions and had a chance to push back before anything is fixed.
The other overlooked point is that BS 5228 compliance is not a compliance exercise, it is a negotiating asset. Contractors who model realistically, including worst-case scenarios rather than averaged ones, consistently secure looser conditions than those who submit generic figures and hope nobody checks. Prioritise the draft conversation and honest modelling over form-filling speed, and the rest of the process tends to fall into place.
— George
