A utility mapping survey is a PAS 128-compliant investigation that locates, records and classifies underground services before design or excavation work begins. Commission one at three points: during feasibility, when clash-checking a detailed design, and again immediately before any excavation or high-risk dig. Every report you receive should state clearly which parts of the standard it followed and which Quality Levels it achieved for each utility recorded.
Get the timing wrong and the cost lands later, usually as a strike, a redesign, or a stalled excavation team standing idle on site. Get it right, and mapping becomes a design tool rather than a compliance exercise.
Commissioning a PAS 128-compliant utility mapping survey with clearly stated Quality Levels at feasibility, design and pre-excavation stages is the single most effective way to prevent utility strikes and programme delays.
| Point | Details |
|---|---|
| Match quality level to risk | Insist on QL-A physical verification for any utility near foundations, piling or excavation lines. |
| Check the deliverable format | Demand CAD/GIS exports with per-segment metadata, not a single flattened drawing. |
| Name private assets in the brief | Public records stop at the meter, so private drainage and lighting need explicit inclusion. |
| Vet suppliers on evidence | Request sample QL-A records and confirmed NVQ or CICES credentials before awarding the tender. |
| Programme for potholing | Build contingency around verification digs, especially in congested or confined-space corridors. |
PAS 128 is the British specification that governs how underground utility detection and mapping should be carried out and reported in the UK. It exists because utility strikes are expensive, dangerous, and largely preventable when the right detection effort is matched to the right project stage, as I G Surveys sets out in its overview of the standard.
The standard defines four Quality Levels, and understanding the difference matters more than most site teams realise:
Reaching Quality Level A requires physical confirmation rather than a plotted estimate, according to 4M Analytics. A competent supplier tags every individual utility segment, not the whole site, with the quality level it actually achieved, along with the detection method used and a date. Treat any report that assigns one blanket quality level to an entire drawing with real suspicion.
No single method covers every utility on a congested urban site. Matching the technique to the material, the ground, and the confidence level you need is the whole discipline.
Most competent surveys combine two or three methods and cross-reference the results before committing anything to the final drawing. Where a clash is safety-critical, insist on QL-A exposure rather than accepting a plotted GPR trace.
Pro Tip: If your design brief depends on an exact depth or a live/dead determination for a service near a foundation line, do not accept anything below QL-A on that specific segment, even if the rest of the site is mapped to QL-B.
A proper deliverable set gives your design and site teams something they can actually work with, not just a coloured drawing to file away.
Coordinate datum consistency matters more than it sounds. A survey pinned to the wrong datum can shift an entire utility corridor by metres once it is overlaid on your setting-out drawings, an error that only surfaces once someone starts digging in the wrong place.
A survey never guarantees complete detection. Abandoned services, deep congestion, and difficult ground conditions all limit what any method can find, which is exactly why a transparent report flags per-segment confidence and states plainly where verification is missing.
Read the limitations section before you read anything else. A report that buries its caveats, or omits them altogether, is telling you more than the drawing itself.
Procurement is where most of the risk gets managed, or missed. Build your tender brief around what you actually need, not a generic scope.
A vague quality-level claim, a refusal to name detection methods, or no sample evidence of physical verification are all reasons to walk away from a tender.
Expect four phases: desktop record enquiries, on-site detection, verification potholing where required, then reporting and CAD/GIS delivery. A straightforward site can move through all four in a couple of weeks; a congested urban corridor with confined-space entries takes considerably longer.
Build contingency into your programme rather than your budget alone, and align the survey with enabling works so verification data lands before your excavation team mobilises, not after.

Mapping data changes how we sequence demolition and strip-out work, not just where we dig. Knowing which services are live, which are dead, and which sit within a metre of a proposed foundation line lets us plan enabling works that keep programmes moving without stopping for a discovery.
East Anglian sites bring their own pattern of problems: private drainage runs that predate current records, congested corridors under Cambridge’s older streets, and utility company records that simply do not match what is in the ground. We treat every desktop record as a starting point, not a fact, and reconcile it against verified field data before anyone breaks ground, in line with the deep excavation safety planning approach we apply across our groundworks projects.
Pro Tip: Store your utility mapping data against the site’s permanent coordinate datum, not a temporary site grid. It will save the next phase’s surveyor a genuinely painful reconciliation exercise.
A utility mapping survey earns its cost the moment it prevents a strike, but the value compounds when the data feeds directly into how your groundworks team sequences work on site. GCS Contractors builds enabling works, foundations, and demolition programmes around verified utility data from day one, treating the survey as the starting point for safe excavation rather than a paperwork formality.
If you are planning groundworks in Cambridge or East Anglia and want a contractor who reads mapping data properly before mobilising plant, our groundworks and foundation services team can walk through your survey findings and build a sequencing plan around them. For projects still at the design or tender stage, our groundworks subcontractor guide covers how to brief a contractor once your mapping is complete.
Most disputes over utility mapping do not stem from bad detection work. They stem from someone downstream assuming a QL-B trace was as reliable as a QL-A exposure, and designing or digging accordingly. The technology gets the attention, GPR units and EM locators feature in every sales brochure, but the real value sits in the quality level attribution and whether the supplier is honest about where confidence runs out.
Conventional procurement advice tends to fixate on method: “make sure they use GPR and CCTV.” That misses the point. A supplier can run every method available and still deliver a report with no useful confidence data if the attribution is sloppy or blanket-applied across a site. Ask about methods, certainly, but ask harder about how quality levels are assigned per segment.
If there is one change worth making to how you brief these surveys, it is this: stop specifying “a PAS 128 survey” and start specifying quality levels by zone, with sample QL-A evidence required before award. That single shift moves the risk conversation from the report you receive to the brief you write, which is where it belongs.

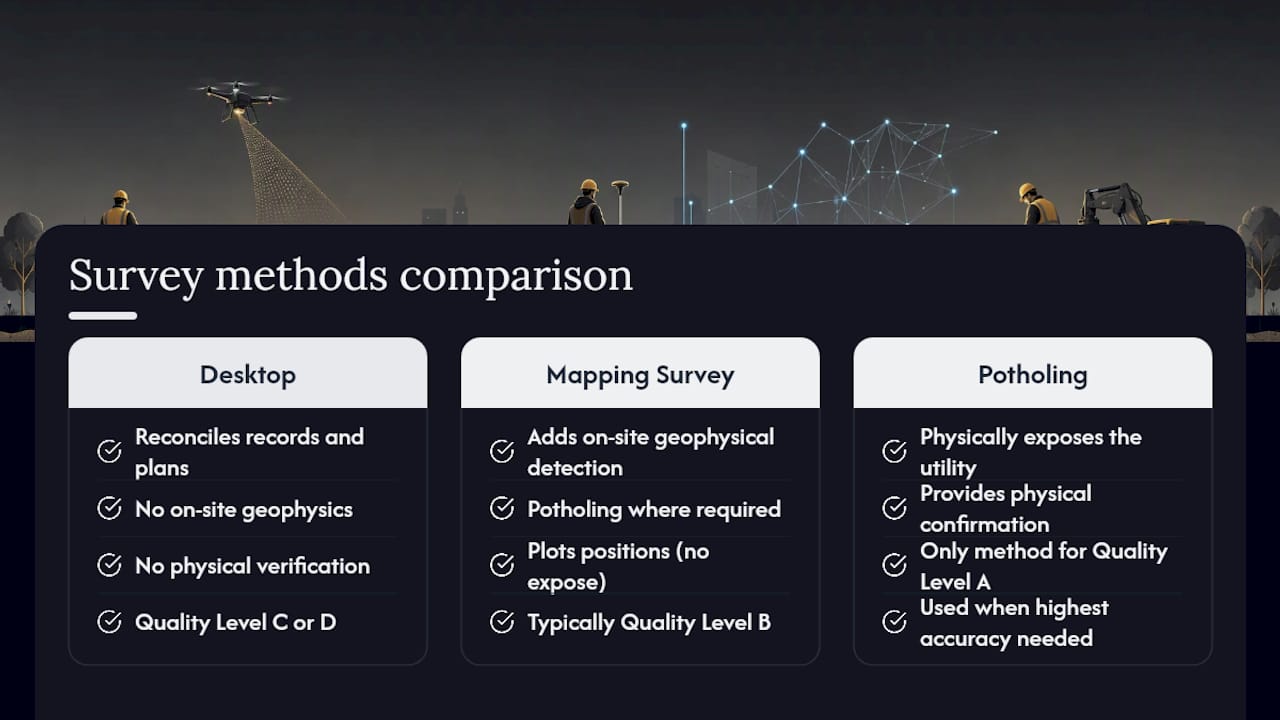

What is the difference between a utility mapping survey and a desktop utility search?
A desktop search only reconciles statutory records and utility company plans, equivalent to Quality Level C or D. A full utility mapping survey adds on-site geophysical detection and, where required, physical verification through potholing.
Does a utility mapping survey cover private services on my site?
Not automatically. Public utility operators typically map only to the meter or point of service, so private drainage, lighting circuits and customer-side pipework need to be named explicitly in your survey brief.
How accurate is ground-penetrating radar compared with vacuum potholing?
GPR provides a plotted position without physical confirmation, generally sufficient for Quality Level B. Vacuum potholing physically exposes the utility and is the only method that achieves Quality Level A.
Can I rely on utility company records instead of commissioning a survey?
No. Relying solely on statutory records or legacy maps is a recognised cause of utility strikes, since these records are frequently incomplete or out of date against what is actually in the ground.

When during a project should I commission a utility mapping survey?
Ideally at feasibility to inform site strategy, again during detailed design to resolve clashes, and once more immediately before excavation begins on high-risk digs.
